Causes of Formwork Failures

formwork failure

Formwork failures usually do not come from one isolated mistake. Excessive load, weak bracing, poor foundations, damaged components, unauthorized changes, premature removal, and human error can combine until one event triggers a blowout or collapse.

The practical lesson is simple: therefore, treat design, erection, inspection, loading, monitoring, and removal as one temporary-works system.

Life-safety warning: formwork and falsework collapse can kill workers and damage the permanent structure. Use the approved design, manufacturer instructions, method statement, and local legal requirements. A competent temporary-works designer and inspector must make project decisions; this article is not a formwork design.

Formwork and falsework are related, but not identical

Formwork gives fresh concrete its shape and surface. Falsework, including shores and supporting frames, carries the formwork, fresh concrete, workers, equipment, and other construction loads until the permanent structure can support them. Site teams sometimes use the terms loosely, but the load path must remain clear.

How several causes combine into one failure

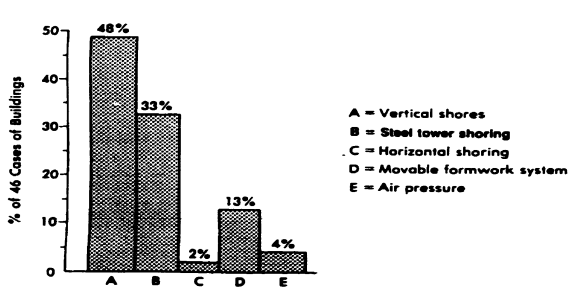

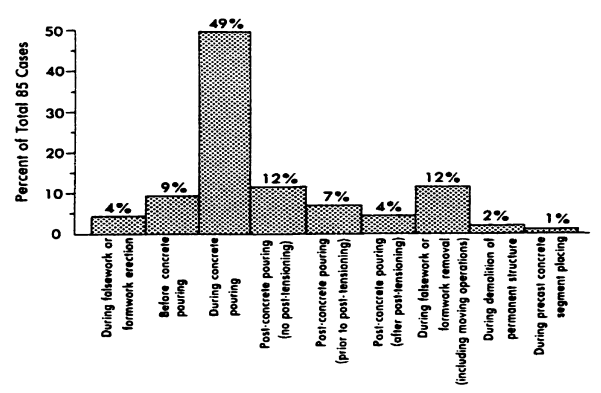

Hadipriono and Wang studied 85 documented major falsework collapses in bridges and buildings and described three kinds of cause:

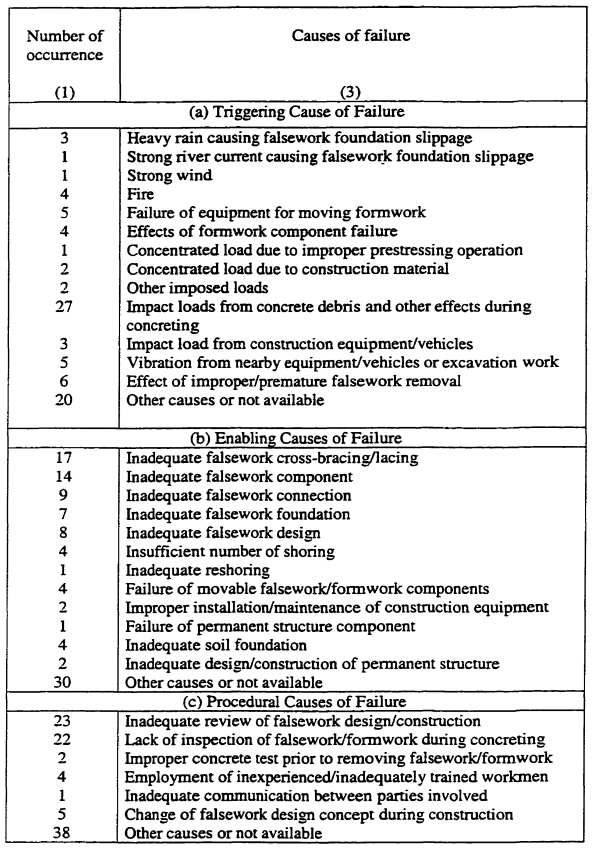

  • Procedural causes: missing design checks, unclear responsibility, poor communication, unauthorized changes, inadequate inspection, or unsafe sequencing.
  • Enabling causes: inadequate bracing, weak connections, damaged members, poor foundations, incomplete erection, or a design/detailing deficiency.
  • Triggering causes: a placing surge, impact, lateral force, wind, vibration, local overload, settlement, or removal step that initiates movement.

A system with sound foundations, continuity, bracing, connections, and reserve can often survive a trigger. However, that trigger can cause collapse when enabling and procedural weaknesses already exist.

Main causes of formwork and falsework failure

Design, bracing, support, and components

Cause Possible failure mode Site check Prevention
Design does not cover actual loads or geometry Member overstress, excessive movement, local or progressive collapse Approved drawings and calculations match the pour, equipment, access, sequence, and proprietary system Competent design; defined vertical, lateral, impact, wind, and construction loads; formal review of changes
Missing or incomplete bracing Sway, buckling, overturning, or internal collapse Longitudinal/transverse bracing, ties, anchors, and connection details are complete Erect exactly to the design; do not remove or relocate braces for access without approval
Weak foundation or base support Shore settlement, tilting, load redistribution, collapse Sills, base plates, ground/bearing surface, drainage, and contact are sound Design the bearing support; protect it from water, erosion, excavation, traffic, and disturbance
Damaged, incompatible, or misassembled components Connection slip, buckling, loss of capacity Components are identifiable, undamaged, compatible, and within manufacturer limits Inspect before use; quarantine damaged parts; follow the supplier’s erection details

Loading, pressure, impact, and removal

Cause Possible failure mode Site check Prevention
Overloading or concentrated loading Local overload followed by progressive failure Concrete is not piled; pump lines, buggies, rebar bundles, and stacked materials are in approved locations Control placement rate and distribution; enforce load limits and exclusion zones
Fresh-concrete pressure exceeds form design Wall/column form bulging, tie failure, or blowout Placement rate, concrete behavior, temperature, vibration, and lift sequence match the design assumptions Use the approved rate and method; monitor form movement and connections continuously
Impact or horizontal force Displaced shore, loss of stability, progressive collapse Vehicle routes, pump movement, crane operations, wind exposure, and edge protection are controlled Physical protection, bracing, communication, and an approved operating plan
Premature stripping or poor reshoring Slab overload, cracking, excessive deflection, or collapse Specified strength evidence, removal sequence, and reshore plan are approved Written release by the responsible competent person; do not strip by calendar alone
Poor inspection or unauthorized change Hidden deficiencies remain until loading Inspection records, revisions, deviations, and sign-offs are complete Hold points before loading, during the pour, and before removal; change-control process

Critical stages

1. Erection and alteration

Many failures begin before concrete arrives. For example, incorrect spacing, missing bracing, unseated heads, poor base contact, mixed components, and field alterations can change the entire load path. A competent person must inspect the erected system against the current design before other trades load it or the supervisor releases the pour.

2. Concrete placement

Fresh concrete, workers, pump lines, equipment, impact, vibration, and lateral actions arrive together. Meanwhile, monitor the system from a safe location as it takes load. Do not allow concrete to accumulate faster or in a different pattern than the design permits. Keep unauthorized people out from under loaded falsework.

3. Stripping and reshoring

Do not remove forms or shores until the permanent concrete can safely carry the required loads and the approved sequence is ready. Moreover, reshoring can shift construction loads through several floors; it is an engineering plan, not just putting a few props back.

Inspection hold points that prevent failures

  1. Before erection: approved design, component schedule, foundations, sequence, access, responsibilities, and manufacturer requirements available.
  2. After erection and before loading: competent-person inspection and written release; deviations closed or accepted by the designer.
  3. Immediately before the pour: braces, ties, connections, shores, base support, platforms, exclusions, load limits, and communication rechecked.
  4. During and immediately after placement: designated observers monitor movement, settlement, leakage, connections, and the load pattern from safe positions.
  5. Before stripping or reshoring change: required strength evidence and the approved removal/reshore sequence confirmed in writing.

Warning signs during a pour

  • Unusual movement, sway, settlement, vibration, or change in level.
  • Leaning shores, opening joints, slipping wedges, deformed members, or distressed connections.
  • Unexpected grout/paste leakage, bulging form faces, tie movement, or cracking sounds.
  • Concrete, reinforcement, equipment, or materials accumulating outside the planned load pattern.
Do not work beneath a distressed loaded system. Follow the project emergency and stop-work procedure, warn the crew, isolate the area, and obtain direction from the responsible temporary-works engineer. Warning signs are not acceptable tolerances; crews must not attempt improvised repairs under load.

The old study is still useful, but it is not today’s incident rate

The Hadipriono and Wang framework remains useful because it shows how management, physical deficiency, and a trigger interact. However, the researchers documented all 85 historical cases before 1986. Therefore, use the framework to understand failure chains, not to claim that the same percentages describe current projects, countries, or formwork systems.

References

Safety rules and competent-person roles vary by jurisdiction. Apply the legally governing requirements for the project location.
